Sections of the stormwater drain below Ferry Road need repairing.

A brick barrel stormwater drain, constructed pre-1900s, lies beneath Ferry Road. Sections of the brick barrel drain are damaged and need to be repaired.

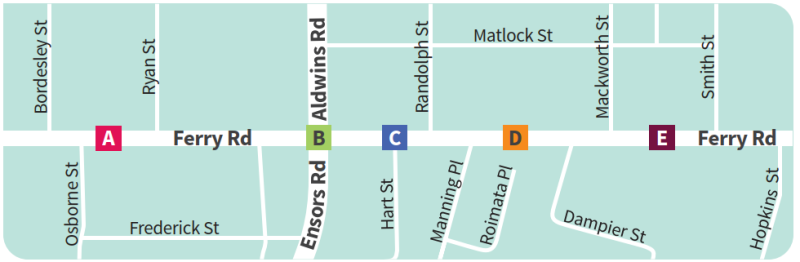

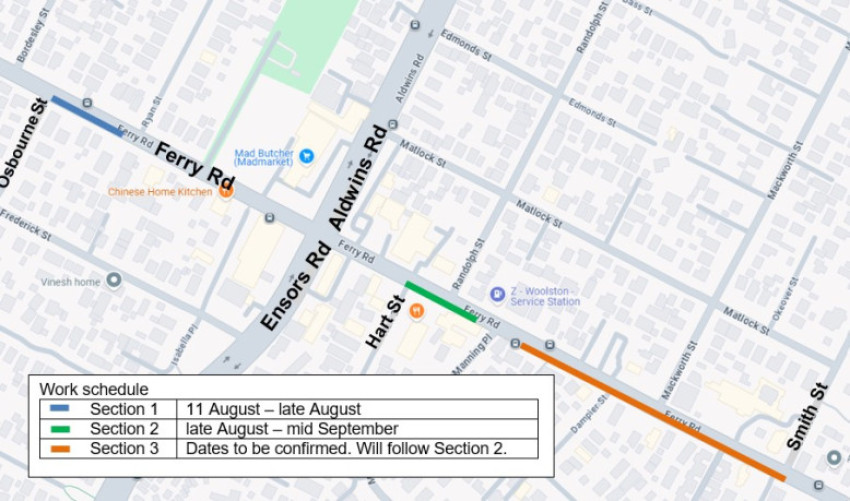

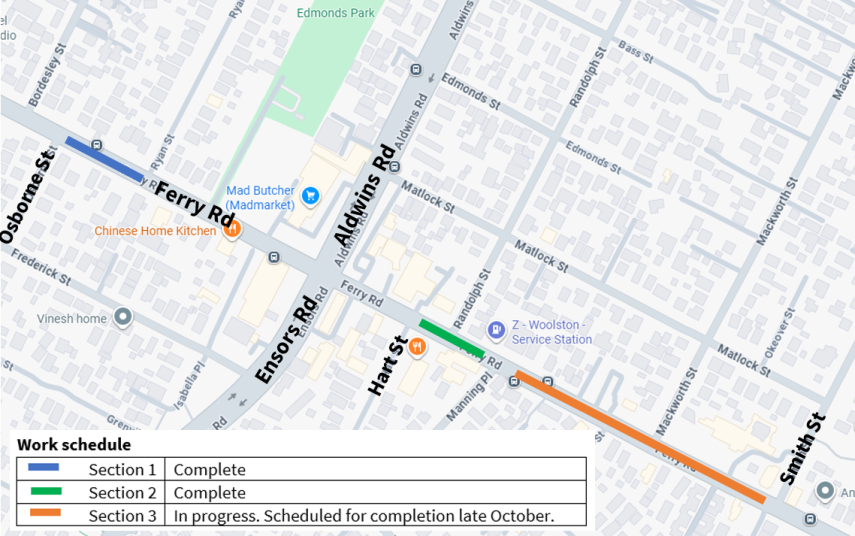

Most of the work to repair the drain took place in early 2024. The final phase of this project is now underway. The work will be staged and completed in three sections, shown on the map below.

Traffic management will be in place to enable the work to be carried out safely.

  • The road width on Ferry Road will be reduced at each worksite during work in that section, but two-way traffic will be maintained for locations near Osborne and Hart Street.

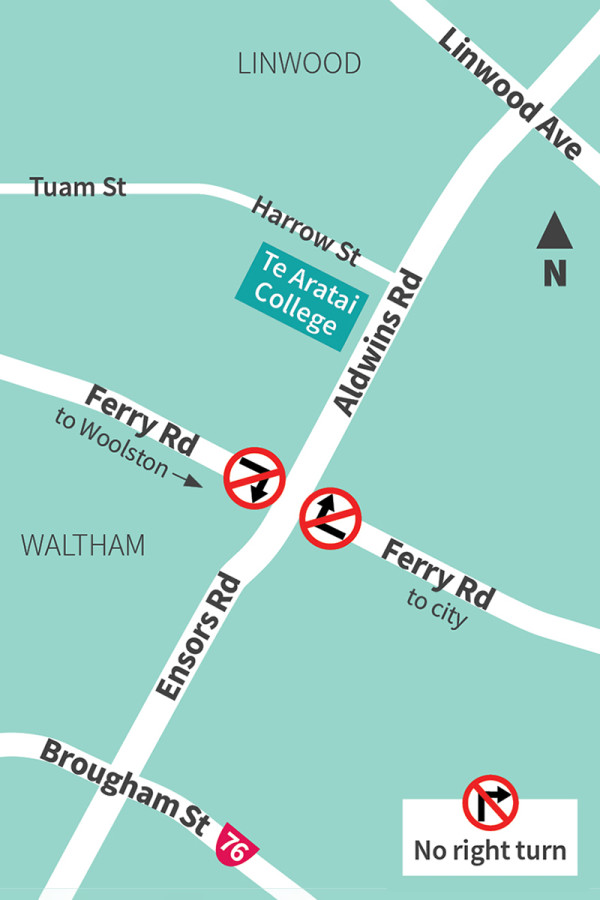

  • A 30km/h speed restriction will be in place.
  • Cycle lanes around the worksites will be closed, and cyclists will share the traffic lane. Cyclists should not overtake vehicles as there is not enough road space. Drivers should take extra caution and be patient with cyclists who may not be able to travel at 30km/h.
  • Please expect delays and allow extra travel time.
  • On-street parking around each worksite area will be temporarily removed during work in that section.
  • Property access will be maintained for most properties. However, restricted vehicle access during work hours will affect properties directly opposite the works.

We distribute works notices and flyers to residents and businesses that are directly affected by the works in their area.
